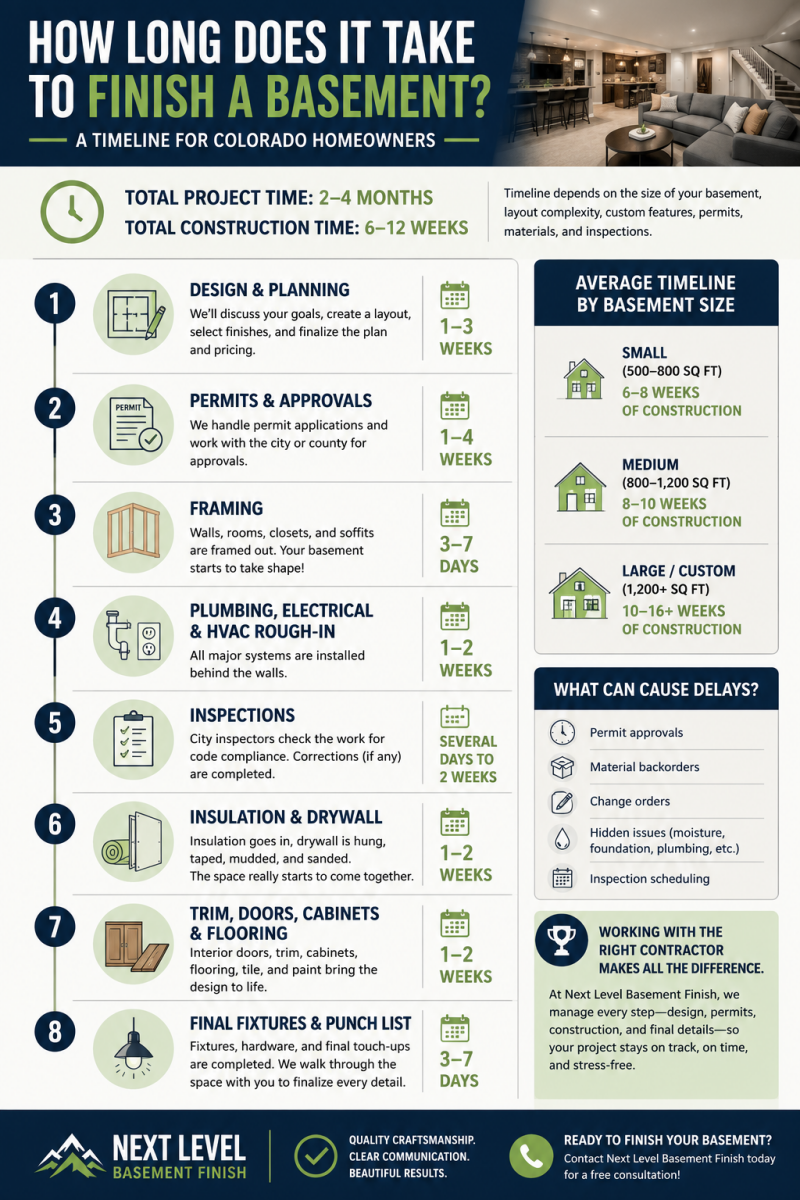

How Long Does It Take to Finish My Basement?

One of the most common questions homeowners ask before starting a basement project is:

"How long does it take to finish my basement?"

The answer depends on the size of the basement, the complexity of the design, permit requirements, and material availability. However, most professionally finished basements in Colorado take 6–12 weeks of active construction, with the entire process typically lasting 2–4 months from planning to completion.

At Next Level Basement Finish, we help homeowners understand exactly what to expect before construction begins so there are no surprises along the way.


Typical Basement Finishing Timeline

Week 1–2: Design & Planning

Before construction starts, you'll meet with your contractor to discuss:

  • Basement layout
  • Bedrooms and bathrooms
  • Home theaters
  • Wet bars
  • Gym spaces
  • Storage areas
  • Lighting and electrical needs

This stage includes measurements, design revisions, budgeting, and finalizing project details.

Estimated Time: 1–2 weeks


Week 2–4: Permits & Approvals

Most Colorado municipalities require permits for basement finishing projects.

Permit requirements typically include:

  • Framing plans
  • Electrical plans
  • HVAC modifications
  • Plumbing plans (if applicable)

Approval times vary by city but generally range from a few days to several weeks.

Estimated Time: 1–3 weeks


Week 4–5: Framing

Once permits are approved, construction begins.

Framing includes:

  • Building walls
  • Room layouts
  • Closet framing
  • Basement bedroom construction
  • Soffits and mechanical room enclosures

This is where homeowners start seeing their basement transform.

Estimated Time: 3–7 days


Week 5–7: Electrical, Plumbing & HVAC

After framing:

  • Electricians run wiring
  • Plumbers install bathroom and bar rough-ins
  • HVAC systems are extended or modified

An inspection is usually required before walls can be closed.

Estimated Time: 1–2 weeks


Week 7–8: Insulation & Drywall

After passing inspections:

  • Insulation is installed
  • Drywall is hung
  • Taping and texture work are completed

This phase dramatically changes the appearance of the space.

Estimated Time: 1–2 weeks


Week 8–10: Paint, Trim & Doors

Now the basement starts looking like a finished living space.

This phase includes:

  • Interior painting
  • Baseboards
  • Door installation
  • Window trim
  • Finish carpentry

Estimated Time: 1 week


Week 10–12: Flooring & Final Fixtures

The final stage includes:

  • Carpet or LVP flooring
  • Bathroom fixtures
  • Lighting fixtures
  • Cabinet installation
  • Final electrical connections

A final inspection is completed before project closeout.

Estimated Time: 1–2 weeks


What Can Delay a Basement Project?

Several factors can affect your timeline:

Change Orders

Making layout changes after construction begins can add days or weeks to the project.

Material Delays

Custom cabinets, specialty flooring, and custom doors often require additional lead time.

Permit Delays

Some municipalities process permits faster than others.

Additional Features

Projects that include:

  • Home theaters
  • Wet bars
  • Full bathrooms
  • Custom built-ins
  • Egress windows

typically take longer than basic basement finishes.


Can a Basement Be Finished Faster?

Yes.

A simple basement with:

  • Open recreation area
  • One bedroom
  • Basic finishes

can sometimes be completed in as little as 4–6 weeks.

Larger custom basements often require 10–16 weeks depending on complexity.


Why Working With an Experienced Contractor Matters

The biggest factor affecting your timeline is often the contractor you choose.

An experienced contractor can:

  • Coordinate trades efficiently
  • Schedule inspections correctly
  • Avoid costly mistakes
  • Keep materials on site
  • Maintain project momentum

At Next Level Basement Finish, our family has over 45 years of construction experience, allowing us to keep projects moving while maintaining quality craftsmanship and code compliance.


Ready to Finish Your Basement?

Whether you're planning a family room, home gym, guest suite, home office, or complete basement transformation, understanding the timeline helps you plan with confidence.

Next Level Basement Finish proudly serves homeowners throughout Castle Rock, Highlands Ranch, Parker, Lone Tree, Centennial, and surrounding Colorado communities.

📞 Call Today: 303-478-2611

Get a free consultation and realistic project timeline for your basement finishing project.
